14 User Guide

Interim Payments

Interim Payments is the page that determines how much a subcontractor will be paid. It gathers the work done on site, the lump-sum payments tied to a contract and the equipment work entries…

1. What it is for

Interim Payments is the page that determines how much a subcontractor will be paid. It gathers the work done on site, the lump-sum payments tied to a contract and the equipment work entries into a single record; it calculates the amount, adds the VAT and writes a credit line to the subcontractor's account.

A single interim payment can carry items from five different agreement types, and they can be mixed in one record: Unit price, Day rate, Lump sum, Deduction and Equipment. The items come from three separate places: work items entered on site, equipment work entries, and lump-sum payments that have no counterpart on site.

The page answers these questions: how much did we issue this month, how much do we owe each subcontractor, what is left on the lump-sum contract, how much was deducted from this interim payment and which record has an item total that does not match.

2. How to open it, who can see it

In the sidebar: Management & Finance › Interim Payments.

Your permissionWhat you can do
ViewYou see the list, the summary band, the chart, the breakdowns, the interim payment panel and the item breakdown. You can take all four exports. New interim payment, editing, deleting, reordering and the ledger transfer are not drawn at all
EditEverything above, plus you issue, edit and delete interim payments, change the sequence and re-run the ledger transfer
No permissionThe module appears dimmed and locked in the menu
NoteNone of the four exports requires edit permission. Taking a report does not change the data; whoever can see the interim payment — typically accounting — should be able to take its certificate too.
Administrators onlyDeleting an interim payment that has a line in the account ledger requires administrator permission. The deletion chain removes the ledger movement first; if that step fails because of permissions the interim payment stays in place and the screen says "The deletion could not be completed. Deleting account transactions requires administrator permission; the record is still in place."
NoteWhen the page opens, some buttons may be missing for a few seconds: the app reads your permissions first and draws the write buttons afterwards. If the permissions cannot be read at all the buttons come up enabled; an attempt to save is then refused by the server.

3. Anatomy of the screen

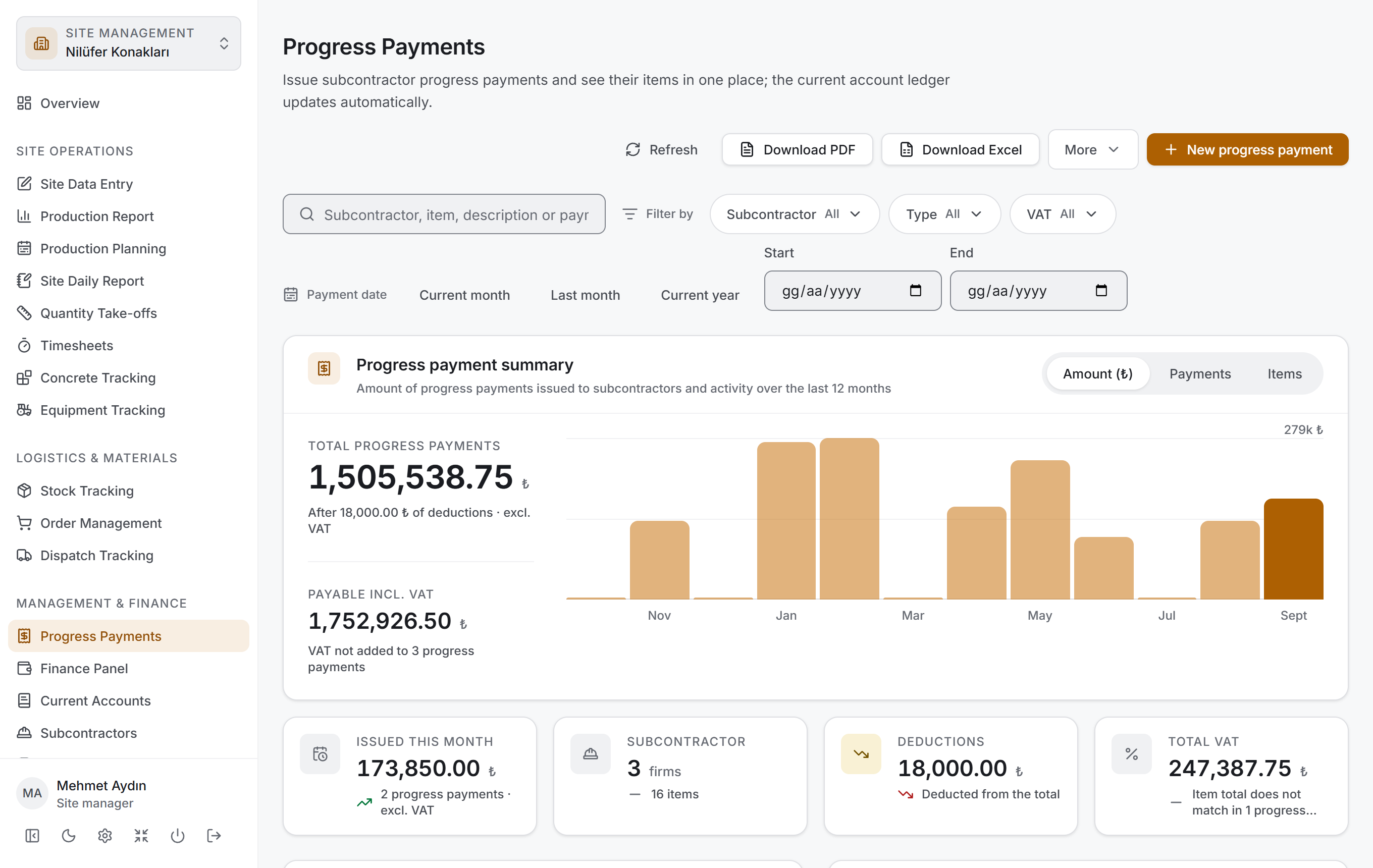

Interim Payments
NoteThe screenshots in this chapter contain no real company data; the project, company, subcontractor and work item names and all figures are examples.

From top to bottom the page has four layers and follows the same order as Concrete Tracking, Timesheets, Equipment Tracking, Inventory, Order Management and Deliveries: first you narrow down, then you read the result as numbers, then you look at its breakdown, and finally you go down to the rows. There is a fifth layer where the inside of an interim payment becomes visible: the interim payment panel that opens when you click a row.

LayerWhat it does
Filter barSearch, subcontractor, type, VAT and valuation date range
Interim payment summaryTwo main amounts, a twelve-month chart, four small measures
BreakdownType distribution and subcontractor distribution
Interim paymentsA table grouped by subcontractor
Interim payment panelA payment's details, its actions and its item breakdown

All four of the first layers are drawn from the rows that pass the filter above. When you make a selection, all four change at once and no request goes to the server — the project data has been loaded once. Every calculation on the page, including the lump-sum balance, comes out of those loaded rows.

Title and actions. The title reads Interim Payments with the description "Issue subcontractor interim payments and see their items in one place; the account ledger updates automatically." On the right sit Refresh, Download PDF, Download Excel, the More menu and (if you have permission) New interim payment. The More menu holds Subcontractor balance statement and — if you have permission — Edit sequence.

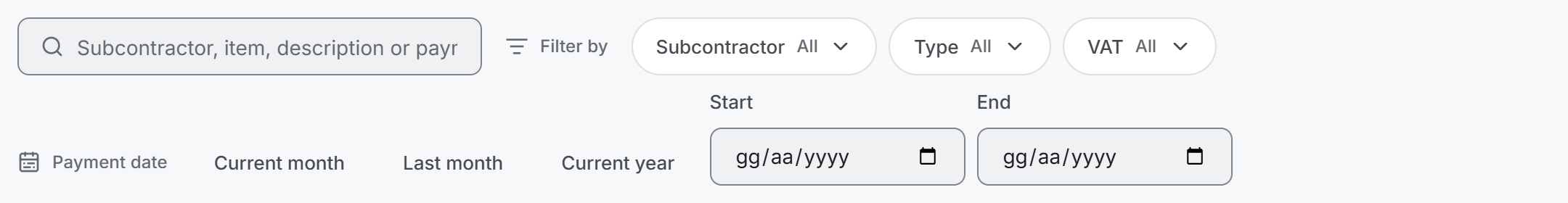

Filter bar

Filter bar

It has two parts. On top a Search interim payments box and next to it, under the Filter by label, the Subcontractor, Type and VAT filters; below, under the Valuation date label, three ready-made ranges and two date boxes. When a filter is active a Clear filters button appears and the number next to it says how many narrowings are open; with no filter the button is not drawn.

ControlWhat it does
Search interim paymentsSearches the subcontractor name, description, payment number, type name and item names and locations. Typing no 3 or just 3 brings up the third payments
SubcontractorNarrows down by company. Records with no subcontractor and with a deleted subcontractor are listed as their own groups
TypeNarrows down by agreement type: Unit price · Day rate · Lump sum · Deduction · Equipment
VATTwo options: With VAT and Without VAT
Current month · Last month · Current yearReady-made ranges. The selected one is highlighted; pressing it a second time removes the range
Start · EndA free valuation date range. If one is left empty there is no limit in that direction

The ready-made ranges here are monthly and yearly — in Deliveries they are weekly. The questions an interim payment answers are "what did we issue this month" and "how much did we pay this subcontractor this year".

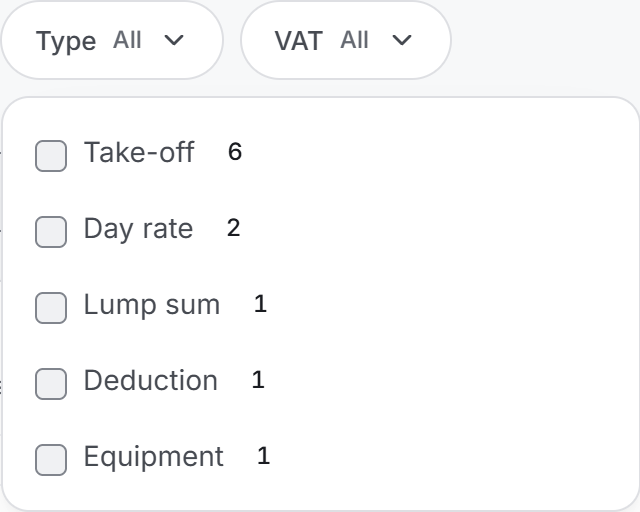

Type filter

In a filter menu each option carries how many interim payments it matches. These counts are calculated after the other filters have been applied; so when you pick a subcontractor, the counts in the type menu describe that company's payments. An option you have selected stays in the list even if the narrowed filter makes it disappear (with a zero next to it).

NoteThe type filter includes, it does not equal. A mixed interim payment that contains a deduction item stays in the list when Deduction is selected. Were it an equality test, mixed payments would appear under no type selection at all.

Interim payment summary

Interim payment summary

On the left two main amounts, on the right the chart of the last twelve months, below four small measures.

MeasureWhat it says
Total Interim PaymentsThe excl. VAT total of the payments that pass the filter. If there are deductions, the line below says how much was subtracted
Payable incl. VATThe net amount plus the VAT — the figure accounting will pay. If any payment has no VAT, the count appears below
Issued This MonthThe excl. VAT total issued in the current calendar month; the count below
SubcontractorHow many companies received a payment; the total item count below
DeductionsThe total of the deduction items. Above zero the tile reads orange
Total VATThe total of the VAT amounts. If any record's item total does not match, the count appears under this tile

The measure of the chart changes with the switch at the top right: Amount, Payments or Items.

NoteThere is a reason the two main amounts stand apart: the project's cost for the subcontractor is the excl. VAT figure, while the payable figure is the one including VAT. Merging them under a single "total" would leave it unclear which question is being answered.
NoteAn interim payment with no date enters no month in the chart, but it is still in the total above. That is the only case in which the chart and the total can differ.

Breakdown

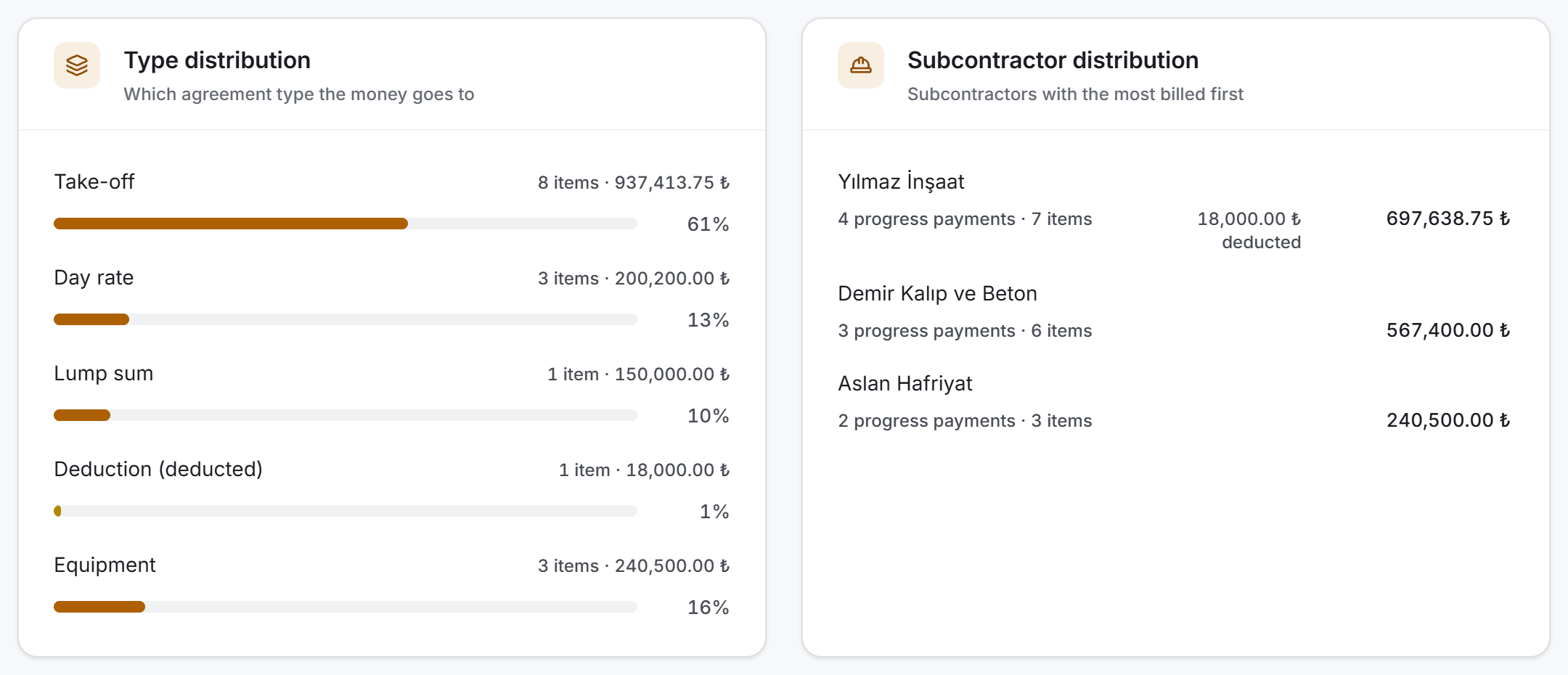

Breakdown cards

Two cards, both counted from the same rows; neither brings an extra request.

Type distribution shows with a bar which agreement type the money goes to. The share is calculated from the amount, not the count: thirty unit-price items could hide that a lump sum took half the money. The deduction row is orange, its label reads (deducted) and its bar is drawn with its absolute value — a negative bar would be unreadable.

Subcontractor distribution counts how much was issued to each company. Every row carries the number of payments, the number of items, any deduction and the excl. VAT amount. The order is by amount; a company that has received nothing shows a dash, not a zero.

NoteThe deduction sits in its own column and is not added to the amount: the amount paid and the amount deducted are not the same figure and adding them would mislead.

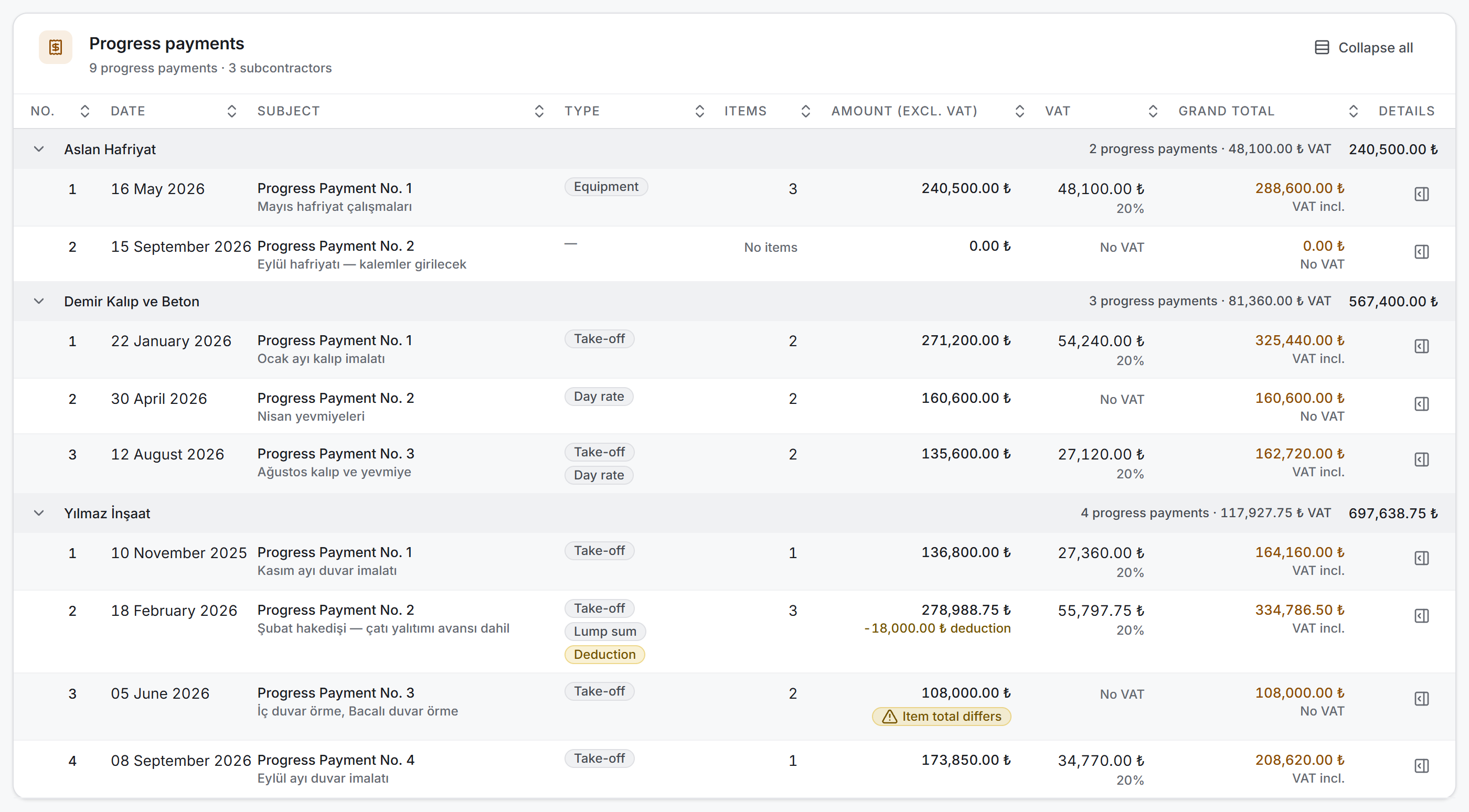

Interim payments

Interim payment list

The table is grouped by subcontractor and the groups are alphabetical. The group header carries that company's payment count, its VAT total if any, and its excl. VAT amount. You can collapse groups by clicking their headers, or collapse all of them with Collapse all at the top right.

ColumnWhat is in it
No.The payment number. It starts from 1 within the subcontractor group
DateThe valuation date; if none was entered, No date. Undated records sort to the end
SubjectInterim Payment No. n and below it the payment's summary — the description if there is one, otherwise the first two item names and the rest as a count. Clicking it opens the panel
TypeThe types present among the items, as badges. Deduction is orange, the rest neutral
ItemsThe item count. A payment with no items reads No items, not zero
Amount (excl. VAT)The recorded net amount. If there is a deduction, -amount deducted appears below; if the item total does not match, an Item total differs badge appears
VATThe VAT amount and its rate below. A payment without VAT reads No VAT — not zero
Grand totalThe net amount plus VAT; below it VAT incl. or No VAT
DetailsOpens the interim payment panel

You can sort by clicking the column headers. The default order inside a group is the payment number.

NoteThe alphabetical grouping is deliberate: the job of the table is to find a record, and people look for a subcontractor by name. The answer to "which subcontractor got the most money" is on the breakdown card, where the order is by amount.

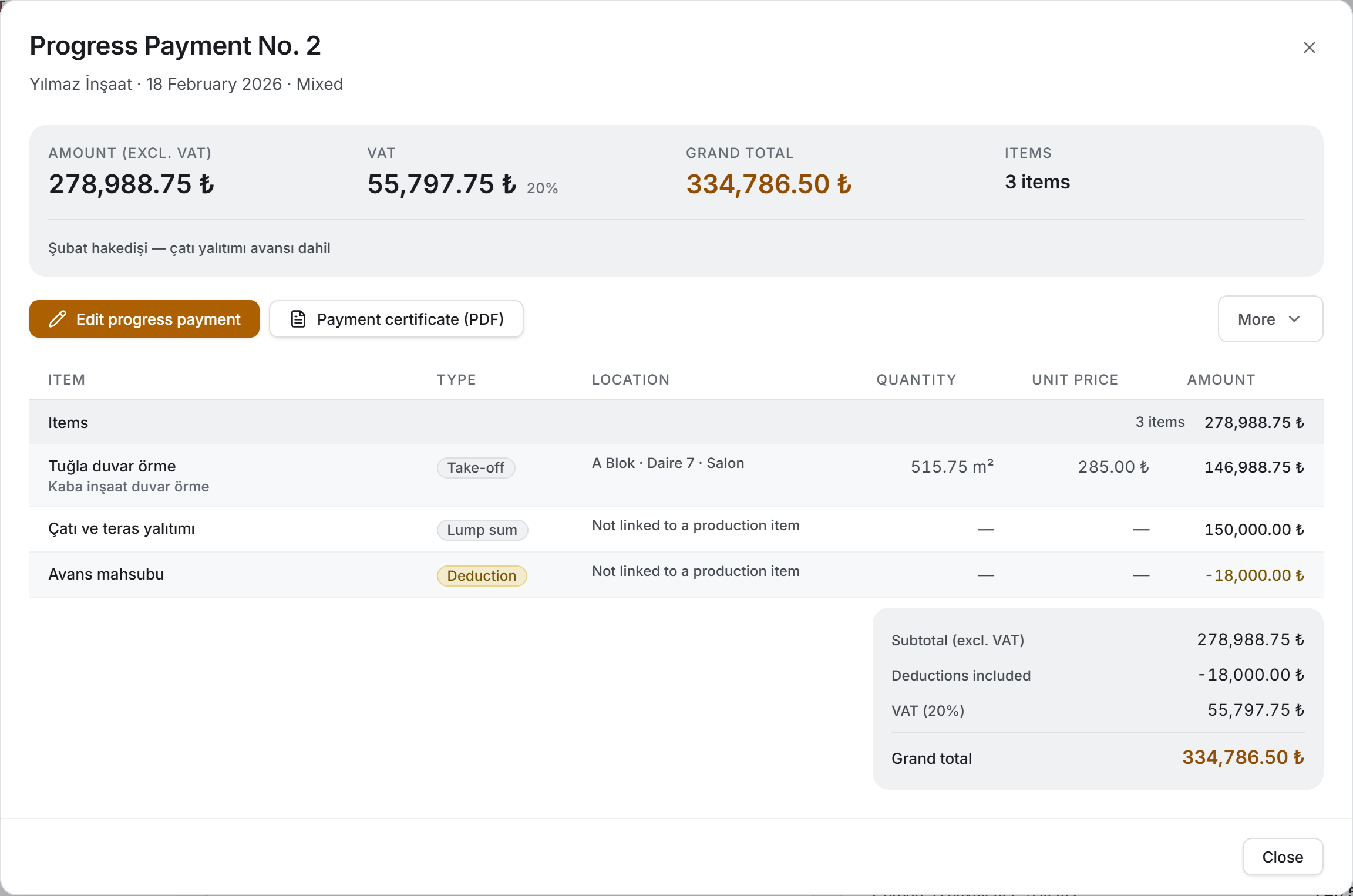

Interim payment panel

Interim payment panel

It opens when you click the Subject column of a row or the Details button. The title reads Interim Payment No. n and below it the subcontractor · date · type. It has three parts.

Details. Four fields: Amount (excl. VAT), VAT (with its rate if there is one), Grand total and the Items count. Below them the payment's description, if any. Two warnings also appear here: an orange band explaining why the item total differs from the recorded amount, and a blue band if no item is linked at all.

Action row.

ButtonWhat it does
Edit interim paymentOpens the payment window in edit mode
Payment certificate (PDF)Prepares the one-page document to be signed with the subcontractor
MoreEdit sequence · Resend to Accounts · Delete interim payment

Item breakdown. The payment's ledger; described under its own heading below.

NoteIf you edit the payment while the panel is open, the panel refreshes itself — you do not need to close and reopen it. If you delete the payment the panel closes.

#### Item breakdown

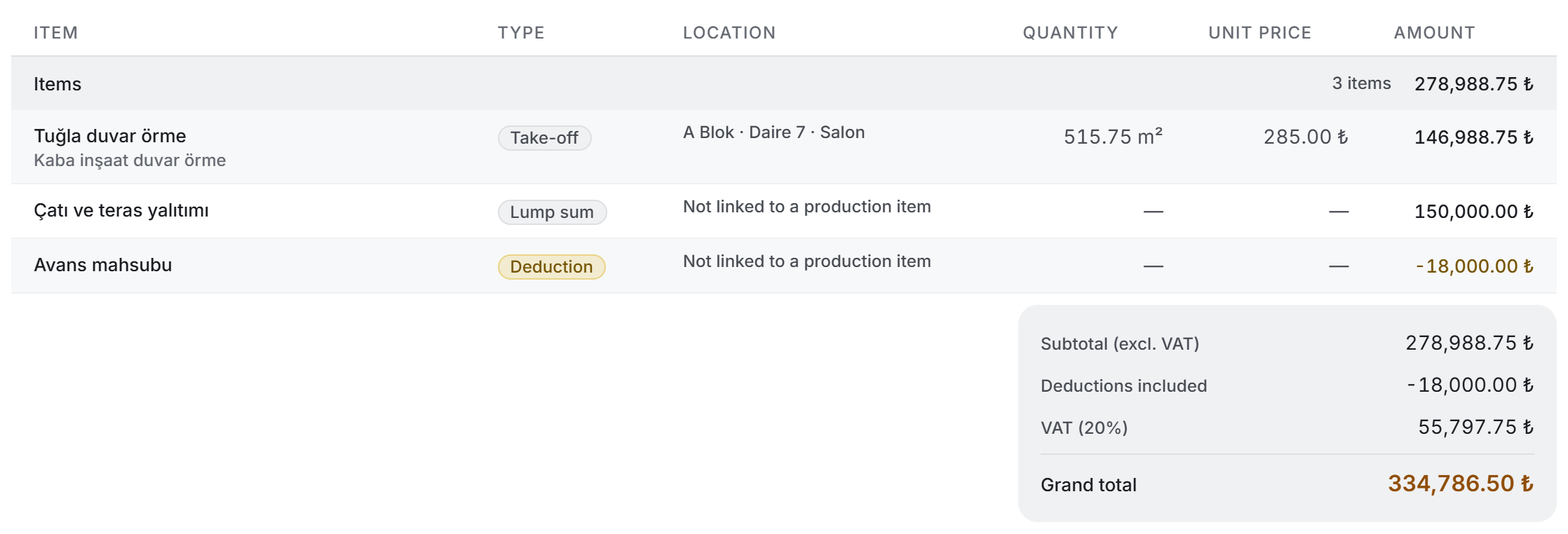

Item breakdown

The items are listed in the order stored in the record; the header says how many there are and their total at the prices on the day of issue.

ColumnWhat is in it
ItemThe item's name and below it the subject of the agreement it belongs to
TypeThe agreement type badge; deduction is orange
LocationFor a work item, Building · Unit · Area; for an item not linked to one, Not linked to a work item; for an equipment item, the date of the work entry
QuantityThe quantity with its unit. There is no such thing as a quantity for lump sum and deduction, so a dash appears
Unit priceThe unit price on the day the payment was issued (the agreement's current price if that is not known). A dash for lump sum and deduction
AmountThe item's amount. A deduction row is written with a minus sign and in orange

Below the table, right-aligned, sits an amount breakdown: the subtotal (excl. VAT), the deductions included if any, the VAT if any, and the grand total.

For a payment with no items the table is not drawn at all; the blue band in the details already says the same thing.

4. Fields

The fields on the top row of the payment window — they are the same in New interim payment and Edit interim payment:

FieldWhat it meansRequired
SubcontractorThe company the payment is issued to. The items come from this company's agreementsYes
Valuation dateThis date is written to the account ledger. It opens filled with todayYes
Add VATWhen ticked, VAT is calculated and the rate box appearsNo
VAT rate (%)As a percentage, between 0 and 100. A new payment opens with the company's tax rate (20 unless another rate is set in Settings)Yes, if VAT is on
DescriptionA free note. It is also shown on the account ledger line and appears in the list as the payment's summaryNo

The fields of the item picker — used when adding items to the payment:

FieldWhat it meansRequired
AgreementOne of the subcontractor's agreements. Next to it stand its type, its subject, how many pending records it has and how many are already in the selectionYes
Amount payable (₺)Only on a lump sum agreement. The amount to be paid on this interim paymentYes
Amount to deduct (₺)Only on a deduction agreement. Do not enter a minus sign — the type marks it as a deductionYes
Work itemsThe unbilled work items under the agreement. At least one must be selected for unit price and day rateDepends on the type
Work items in scopeOn lump sum and deduction the same list is optional: the item may have no counterpart on siteNo
Work entriesOnly on an equipment agreement. The unbilled work entries; at least one must be selectedYes

Calculated values — these are not entered by hand, they come out of the record:

ValueHow it is calculated
Payment No.The number within the subcontractor group. A new payment takes the group's highest number plus one, and the number is stored with the record; a manually set sequence wins
Item amountFor unit price and day rate, quantity × unit price — the agreement's current price on a new payment, the price on the day of issue on an issued one; for equipment, the recorded amounts of the work entries; for lump sum and deduction, the amount entered by hand
Amount (net)The total of all items in the selection — with deductions subtracted
VAT amountNet × rate ÷ 100. Zero if VAT is off
Grand totalNet + VAT
Item totalThe total of the items at the prices on the day of issue (today's prices if those are not known). If it differs from the recorded amount by more than one kuruş, a badge appears
DeductionThe total of the deduction items, as an absolute value
Remaining contract sumFor lump sum and deduction: contract sum − billed on other payments − other rows in the current selection
NoteIn the amount boxes you may use a comma or a full stop for decimals; do not type a thousands separator.

5. Step by step

Issuing an interim payment

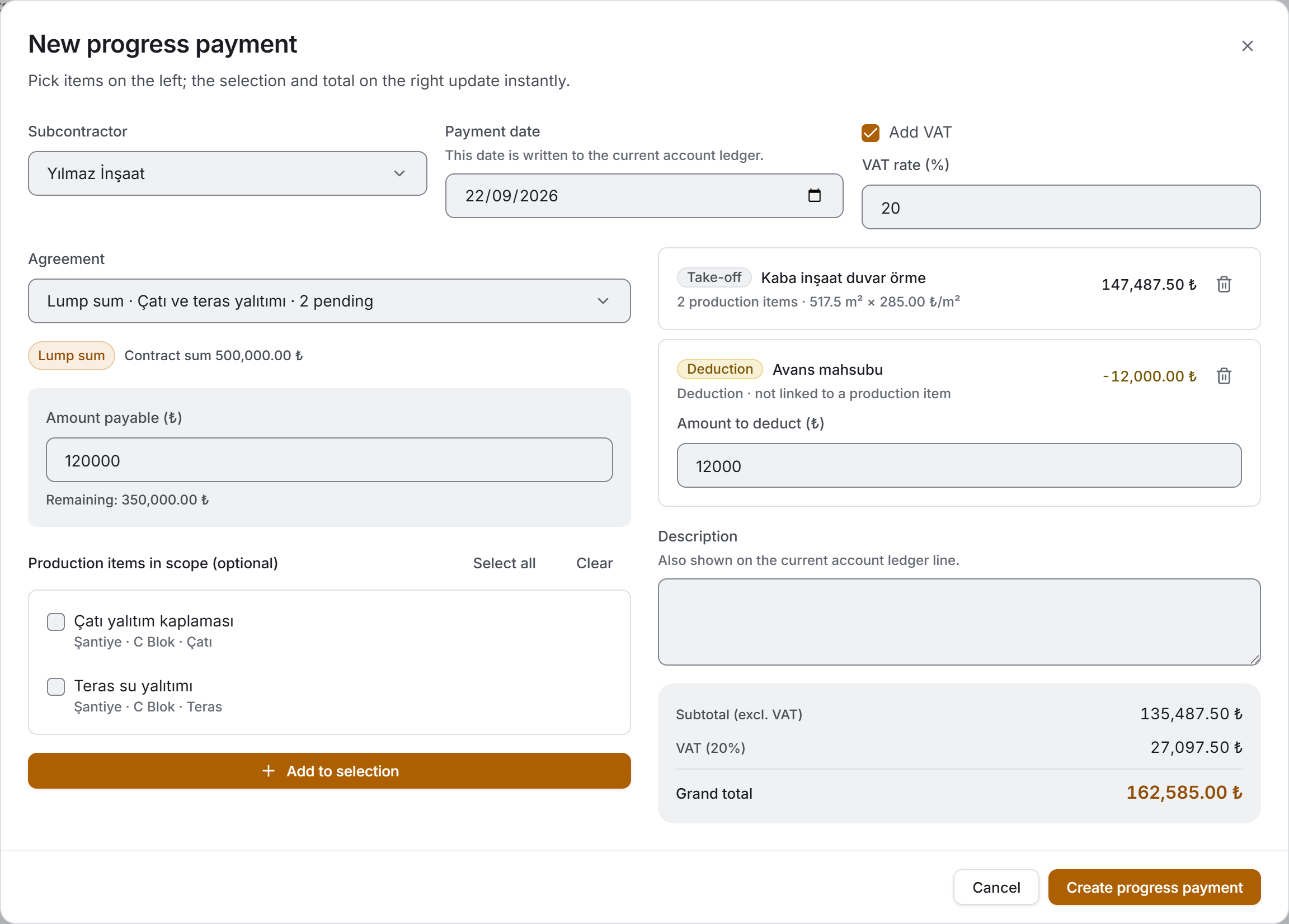

New interim payment

The window has two columns: the item picker on the left, the selection and the total on the right. The selection and the total update instantly with every pick; while you add the second item you can see the amount of the first.

  1. In the title bar choose New interim payment.
  2. Pick a Subcontractor. Until you do, the columns are not drawn and "Select a subcontractor first" appears in their place.
  3. Check the Valuation date — it opens filled with today.
  4. If you need to, tick Add VAT and enter the rate.
  5. Add items from the left (described per type below). An interim payment can carry items from more than one agreement, and more than one row from the same agreement.
  6. If you wish, fill in the Description box at the bottom right.
  7. Choose Create interim payment.

Saving does four things: the payment record is created, the selected work items and equipment work entries are linked to it and marked as billed, the lump sum and deduction items that are not linked to a work item are written, and a credit line is posted to the subcontractor's account.

CautionThere is a different error and the two must not be confused: "The interim payment could not be saved; it may have been created without its items linked." Here the links are half-done, so some work items may still be free and a second attempt really would bind them to a second payment. Choose Refresh first; if the payment is in the list, do not create it a second time — edit that record and add the missing items.

Adding an item

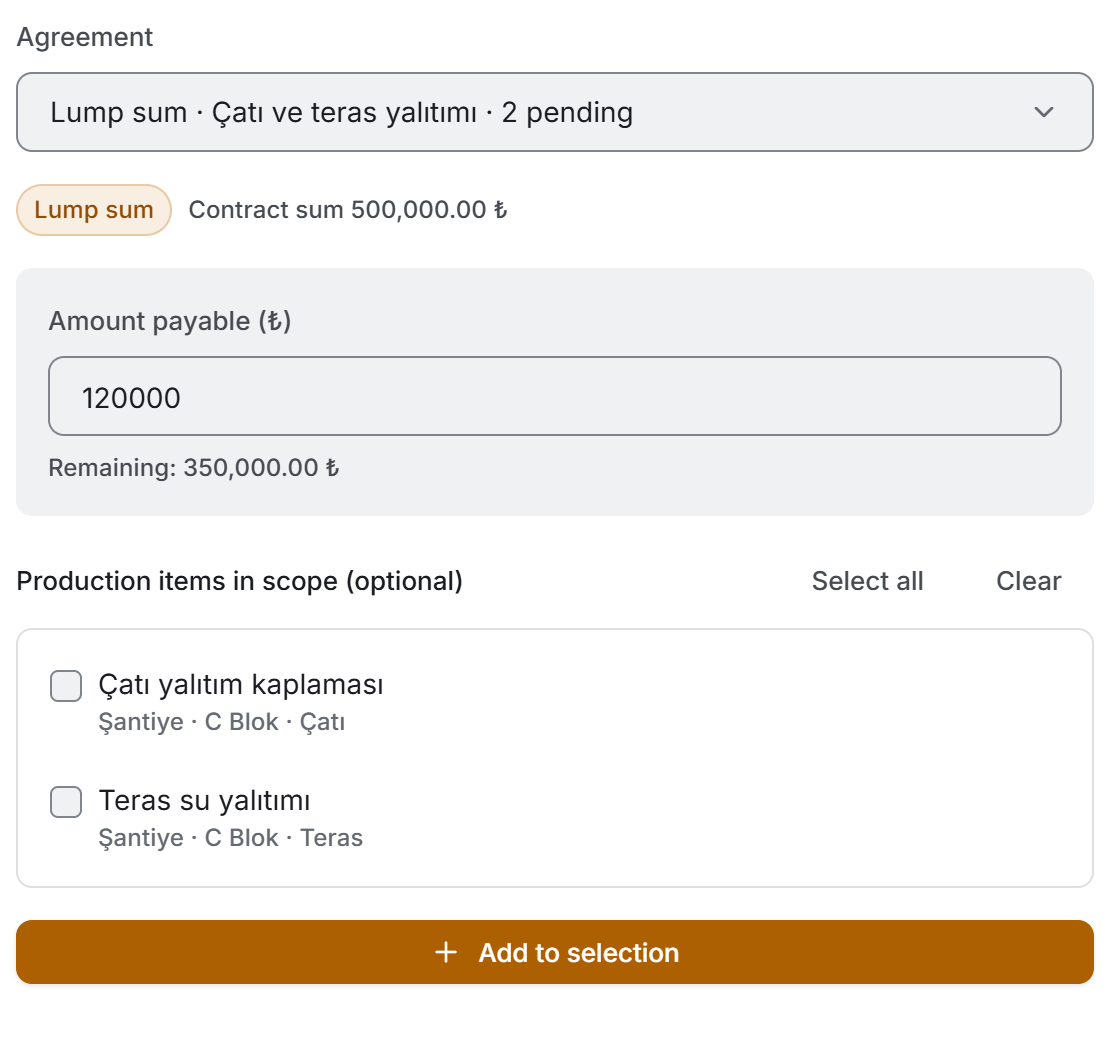

Lump sum item

First pick an agreement from the Agreement box on the left. The option line carries the type, the subject, how many pending records there are and, if any, how many are already in the selection. Once an agreement is picked, the type badge and the price information appear below it; what follows depends on the type:

  • Unit price and Day rate. The **unbilled work items with the status Done under the agreement are listed. Tick at least one. Select all and Clear** save you from ticking forty boxes one by one on a large agreement. The amount is the quantity total of the selected items multiplied by the agreement's unit price.
  • Equipment. The work entries are listed in the same place: date, duration, amount and description. A work entry with no amount reads No amount entered.
  • Lump sum. Enter the Amount payable. Below the box stands the remaining contract sum on that agreement, and it shrinks with every row you add to the selection. If you wish you can spread that amount across one or more work items — the Work items in scope list is optional.
  • Deduction. Enter the Amount to deduct and do not put a minus sign; the type marks it. The item enters the selection with a negative amount and lowers the total.

Finally choose Add to selection. The item drops into the selection on the right, the agreement box empties, and you are prevented from adding the same record twice — the work items and work entries in the selection drop out of the picker list.

CautionOn lump sum and deduction the amount entered cannot exceed the remaining contract sum. When it does, "Only … remains on this agreement; you cannot enter …" appears under the box and the item is not added. The check also counts the earlier rows in the selection.

Correcting or removing an item in the selection

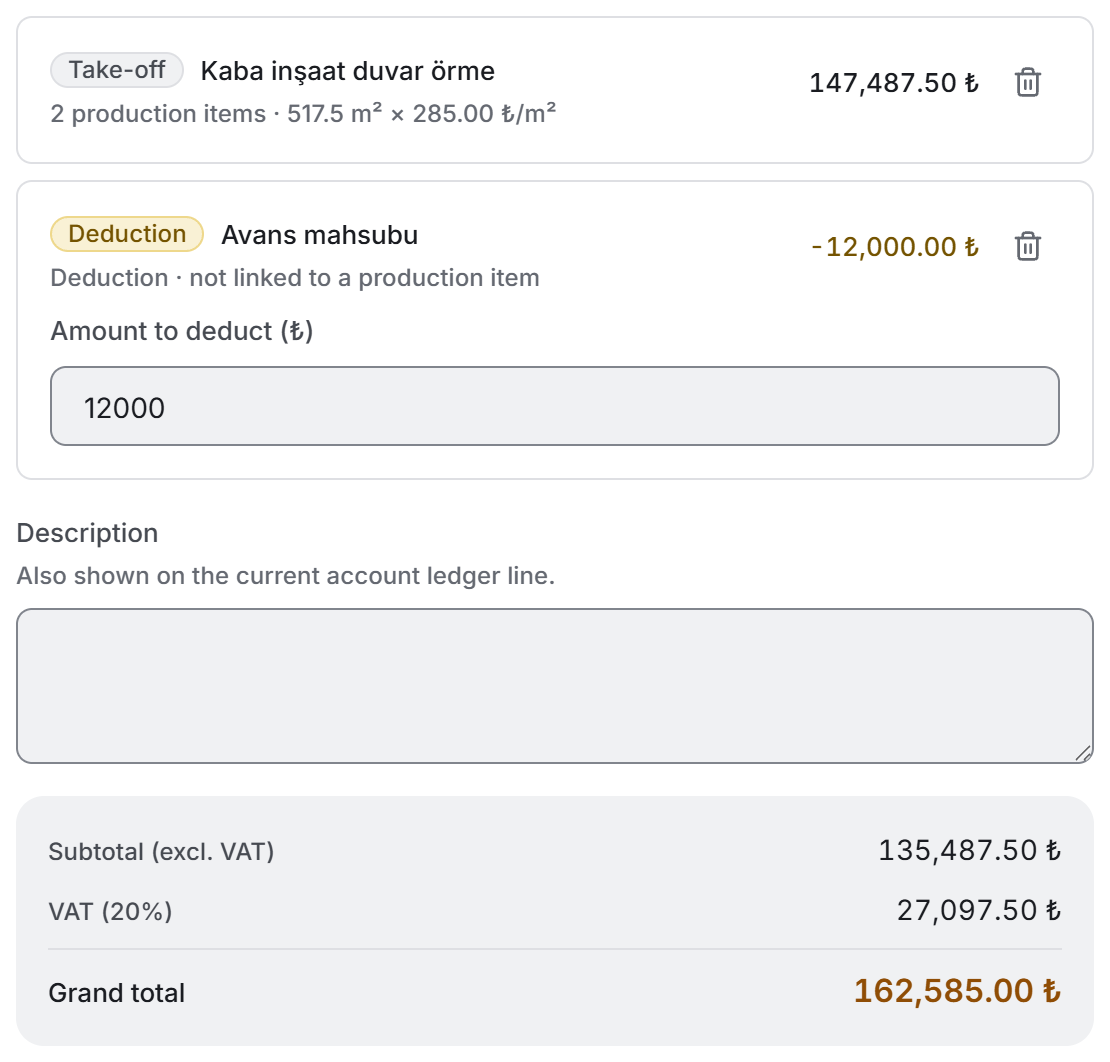

Selection

Every row in the selection carries its type, the subject of the agreement, a one-line summary and its amount. On lump sum and deduction rows the amount box sits inside the row and can be corrected directly — you do not have to remove the item and add it again. The bin button removes the row from the selection.

The total box below the selection writes the subtotal, the VAT if any and the grand total one under the other.

Three situations block saving, and all three are stated in a red band under the selection: if the selection is empty, if a lump sum or deduction row has a zero amount, or if an agreement's contract sum is exceeded.

Editing an interim payment

  1. Open the row and choose Edit interim payment in the panel.
  2. It is the same window; the selection is rebuilt from the saved items.
  3. You can add and remove items, correct the amounts, and change the date, the VAT and the description.
  4. Choose Save.

The subcontractor cannot be changed and the box is locked: every item is tied to that subcontractor's agreements, and changing it would invalidate them all. If you have to change it, delete the payment and issue it again.

CautionIf an orange band saying "Some items could not be added to the selection" appears as the window opens, stop before saving. The agreement, work item or work entry behind those items has changed or been deleted; if you save now they will be removed from the payment and the amount will go down. If that is not what you want, choose Cancel.

Changing the payment numbers

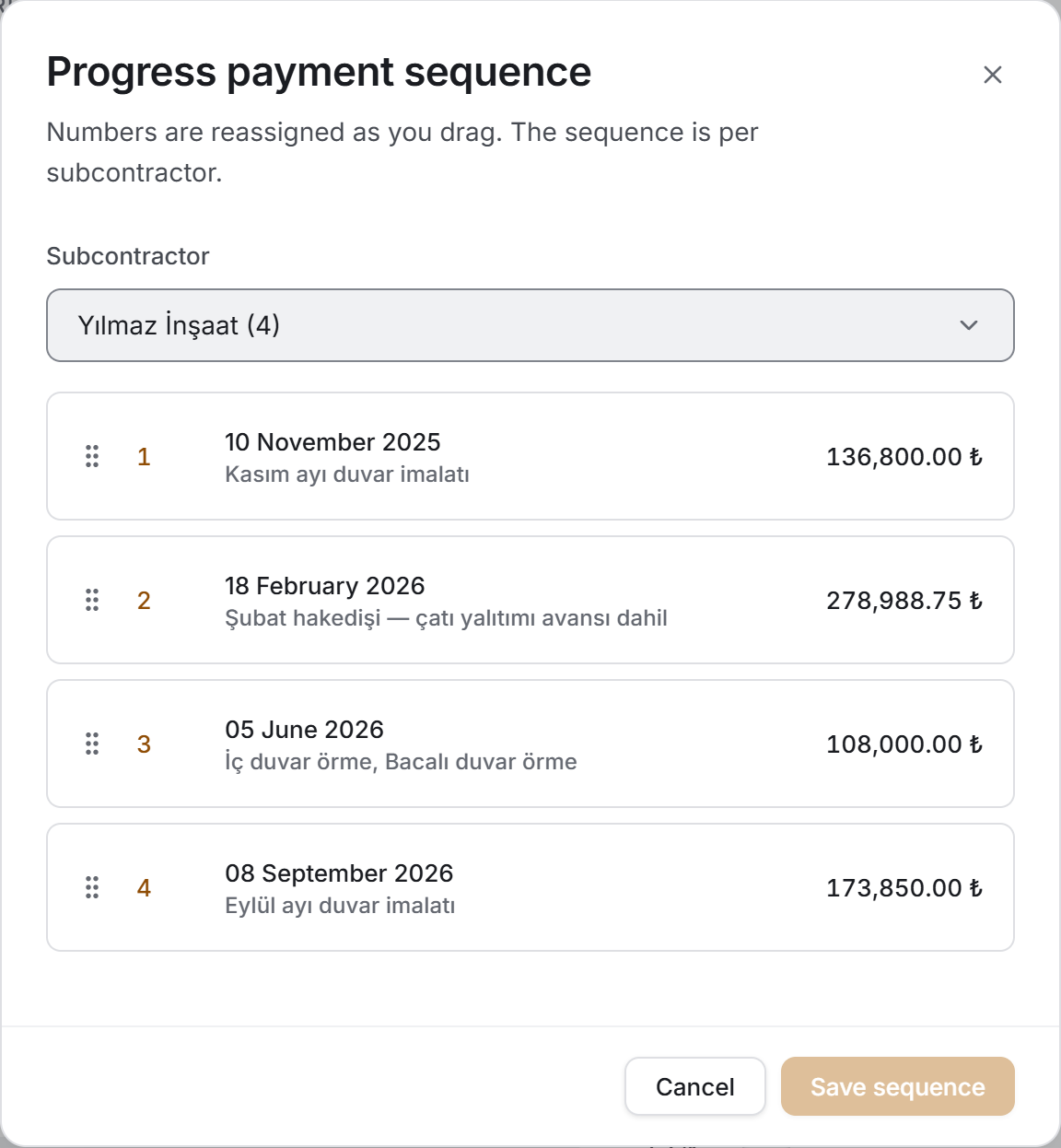

Sequence

The payment number is given within the subcontractor group and stored with the record: a new payment takes the group's highest number plus one. If you set a sequence by hand, that wins.

  1. Choose More › Edit sequence in the title bar, or the same item from the panel — coming from the panel opens it with that payment's subcontractor selected.
  2. If there is more than one subcontractor, pick one from the box at the top. With a single subcontractor the box is not drawn.
  3. Drag the rows by their handles. The numbers are reassigned instantly as you drag.
  4. Choose Save sequence. If nothing changed the button stays disabled.

Deleting an interim payment

  1. Open the panel and choose More › Delete interim payment.
  2. The confirmation window carries the subcontractor, the number and the summary in its title; the amount and how many items will be released are in the orange band.
  3. Choose Delete interim payment.

The deletion order is this: first the ledger movement is removed, then the work items and equipment work entries are released, then the items not linked to a work item are deleted, and last of all the payment record. If any step fails the payment stays in place and you can try again.

The work items and equipment work entries are not deleted; they become available to be added to an interim payment again.

NoteWhen a payment is deleted, the numbers of that subcontractor's later payments do not shift, and the freed number is not given out again. Only Edit sequence changes a number.

Re-running the ledger transfer

If the payment was saved but could not be written to the account ledger, an orange band appears at the top of the page saying "Interim payment saved, but not written to the account ledger." The payment is in the list and its work items and equipment work entries are linked to it; the only thing missing is the line in the subcontractor's ledger.

In that case do not issue the payment a second time: a second record would put a second credit line in the ledger and the same work would look as though it were owed twice. You would not find its items either — the work items and work entries are bound to the first payment and no longer appear in the picker.

Check your connection, open the panel and choose More › Resend to Accounts. There are three possible outcomes: the line is created and "The interim payment was sent to the account ledger" appears; if the payment has no subcontractor or its amount is zero the ledger line is removed and the reason is stated; if there is a permission or connection problem the error appears in its own words.

NoteIf the subcontractor has no account at all the transfer cannot be made and the screen says so; an administrator has to create the account once in Accounts.

6. Exports

There are four exports. Two of them send the list you see on screen out — whatever the filter is, that is what goes into the file; the third describes a single interim payment and the fourth a single subcontractor.

If the save window is closed nothing happens; when it is saved, a band appears at the top of the page with the full path of the file. All four exports can be taken with view permission.

NoteWhen the list is empty Download PDF and Download Excel are disabled. The export of an empty list is an empty file.

Download Excel

The file name starts with Interim_Payment_Report_ and a date–time stamp is appended. The workbook has two sheets, because it answers two separate questions: the first is "how much did we pay whom", the second "what work did we pay for".

The Interim Payments sheet carries eleven columns: Subcontractor · No. · Date · Subject / Description · Type · Items · Amount (₺) · VAT (%) · VAT Amount (₺) · Grand Total (₺) · Deductions (₺).

The Items sheet writes all the items of the payments in the same filter across twelve columns: Subcontractor · Payment No. · Date · Item · Type · Building · Unit · Area · Quantity · Unit · Unit Price (₺) · Amount (₺).

Above both sheets sit three header lines: the project name; the report date and the totals; and a one-line summary of the filter that was applied. That last line matters — it is written so that a file taken with a subcontractor selected is not mistaken for the whole project when it is emailed. The deduction total and the number of records whose item total does not match are also noted in the header if there are any.

Three useful details: the header row comes frozen; the filter is on; and the dates and all the numbers are real cell values — they can be sorted, summed and pivoted. The grand total column is bold and highlighted, the deductions column is orange; on the Items sheet the amount of a negative row is orange too.

The last row of both sheets is the GRAND TOTAL, and every total sums its own column. On the Interim Payments sheet the item count, the amount, the VAT, the grand total and the deductions are summed.

NoteOn the Items sheet the Quantity cell of lump sum and deduction items is empty. There is no such thing as a quantity for those types; writing the amount there would mean adding money to square metres when the column is summed.

Download PDF

An A4 landscape status report with nine columns: Subcontractor · No. · Date · Subject / Description · Type · Items · Amount (₺) · VAT (₺) · Grand Total (₺).

The first page carries the project name, the Interim Payment Report subtitle, the time it was produced and the filter summary; at the top right the excl. VAT total, the payment and subcontractor counts and, if any, the incl. VAT amount and the deduction warning. From the second page on, a thin band repeats at the top, the column headers are rewritten on every page and the page number sits at the bottom.

The deduction is noted in orange below the amount. On a payment whose item total differs from the recorded amount, an italic line reading "item total …" is added under the subject — accounting works with this file and should know why the numbers do not match.

The last row is the GRAND TOTAL: the item count, the amount, the VAT and the grand total columns are summed.

NoteFor a list of more than a thousand rows you are asked to confirm before the PDF is prepared: during preparation the window may stop responding for a while and the operation cannot be stopped. The Excel export is fast even at that size.

Payment certificate (PDF)

This is the document signed with the subcontractor, and it is taken from the interim payment panel. The file name is made of Payment_Certificate_, the subcontractor's name and the payment number.

It is an A4 portrait document and carries:

  • The PAYMENT CERTIFICATE title, the project name, the Interim Payment No., the Document reference, the time it was issued and the valuation date.
  • Two parties: SUBCONTRACTOR (the firm) and ISSUED BY (the project · site management).
  • A four-box summary: ITEMS, TYPE, DEDUCTIONS, VAT. If the item total differs from the recorded amount, a note stating the difference sits below.
  • An item table: every item's name, agreement, type, location, quantity, unit price and amount.
  • The amount breakdown: Subtotal (excl. VAT), VAT (…%) if any, and the GRAND TOTAL.
  • A NOTES section if there is anything to say: the payment's description and the sentence stating the deduction.
  • Two signature areas: Subcontractor / Stamp · Signature and Site management · Signature.
NoteThe Document reference is derived from the record's identity and does not change — the same payment gives the same reference every time it is printed. The Interim Payment No. is stored with the record but can be changed with Edit sequence. That is why the document carries both.
NoteThe document comes out in the language the app is in at that moment; if you want to give the subcontractor a Turkish certificate, switch the language and take it again.

Subcontractor balance statement (PDF)

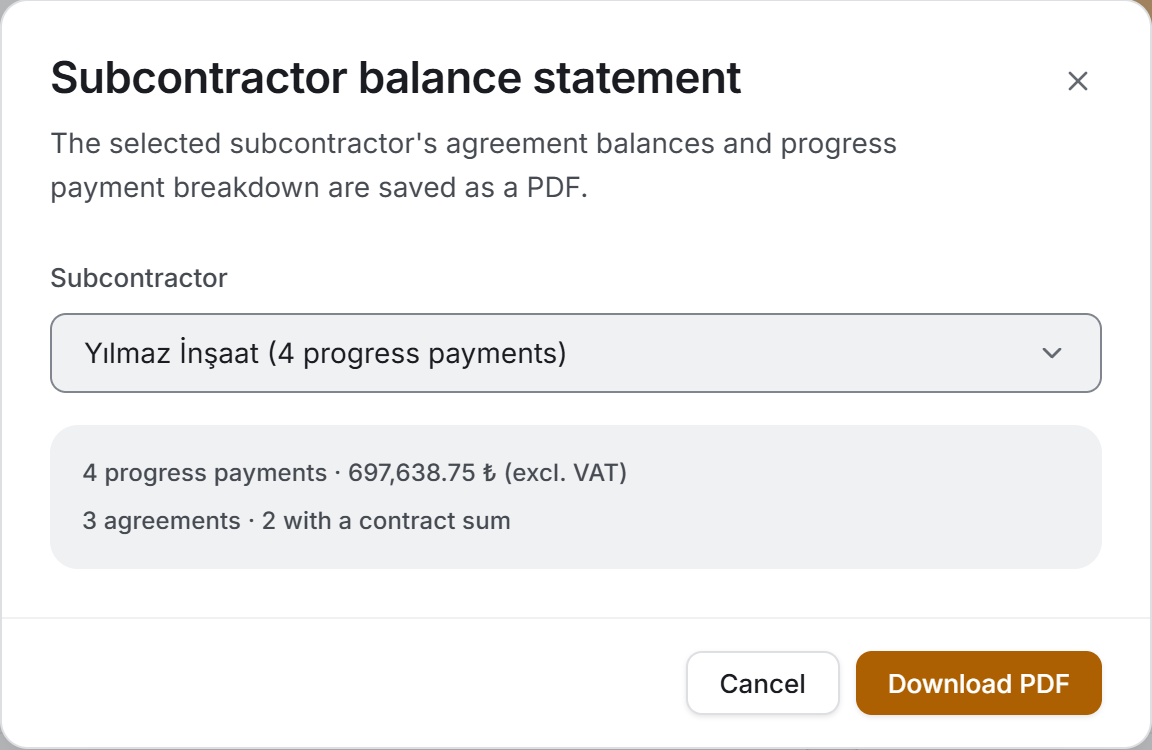

Balance window

This is the document that shows how much has been billed against each agreement of a subcontractor and how much is left. It is taken with More › Subcontractor balance statement in the title bar.

  1. If there is more than one subcontractor, pick one from the box at the top; the number of payments it has is written next to it.
  2. The grey box below the window summarises the selection: how many payments, the total amount, how many agreements and how many of them have a contract sum.
  3. Choose Download PDF.

The file name is made of Balance_Statement_, the subcontractor's name and a date–time stamp. The A4 portrait document has two tables:

  • AGREEMENT BALANCES — Agreement · Type · Unit Price · Contract sum · Billed · Remaining. Agreements with a contract sum come first. Unit-price, day-rate and equipment agreements are open-ended and read Open-ended in the Remaining column; a zero there would read as "finished".
  • INTERIM PAYMENTS — No. · Date · Type · Items · Amount · VAT · Grand Total, with a TOTAL row below.
Caution — known defect The balance statement is calculated from the payments that pass the filter on screen, but the document does not say which filter was applied. If you take the statement with a period selected, Billed looks smaller than it is and Remaining larger. Clear the filters before taking this document.
Caution — known defect The subcontractor list also contains the No subcontractor selected group. If it is picked, the document is produced empty: those records have no company behind them and therefore no list of agreements.
NoteIf the project has a single subcontractor the selection box is not drawn and the subcontractor's name is never shown in the window. You can read the name on the document itself.

7. What you need to know

All the money totals on the screen are excl. VAT. The project's cost for the subcontractor is the excl. VAT figure; the VAT goes to the state and is offset. The VAT does not disappear: it is in its own tile on the summary band, in its own column in the table, in the panel's amount breakdown and on its own line in every export.

The amount of an issued interim payment is frozen. Every total on the page sums the amount written in the record — not one recalculated from the items. The items, too, are shown not at the agreement's current price but at the unit price on the day the payment was issued: the prices are stored with the payment when it is saved, and for older records the day's price is derived from the recorded amount. If the agreement's price changes later, the issued payment does not; the recorded amount is what applies and it is what was written to the account ledger.

If a separation remains, it is not hidden. When the day's price cannot be found (an older payment without stored prices that has items from more than one agreement), the items are counted at today's prices and their total may separate from the recorded amount. An Item total differs badge appears in the table, a band explaining why in the panel, the number of affected records under the VAT tile, and a line each in the Excel header and in the PDF. The panel band usually explains the cause as the agreement's price having changed later.

The payment number is stored with the record. It starts from 1 inside the subcontractor group; a new payment takes the group's highest number plus one, the later ones do not shift when a record is deleted and a freed number is not given out again. Older records without a stored number are fixed at the number they show today the first time that subcontractor's payments are saved, edited or deleted. Only Edit sequence changes the number; the one that never changes is the Document reference on the certificate.

A deduction lowers the money; the type sets the sign. You do not type a minus sign when entering a deduction; the item enters the selection with a negative amount, lowers the total and reads orange everywhere. On the breakdown card, however, its bar is drawn with its absolute value — a negative bar would be unreadable.

The lump-sum balance is calculated from three sources: the contract sum, what has been billed on other payments, and the rows currently in the selection. You are prevented from adding two rows from the same agreement and spending the balance twice. This calculation does not go to the server; moving around the picker list triggers no request.

An interim payment touches four ledgers at once: its own record, the work items on site, the equipment work entries and the subcontractor's account. The first three are written in a single operation; the ledger is reported separately.

If the ledger transfer fails, the payment has still been saved. A band appears on screen saying "Interim payment saved, but not written to the account ledger." The record and its links are complete; the only thing missing is the line in the subcontractor's ledger. Do not issue the payment a second time — a second record would open a second credit line in the ledger. Use the Resend to Accounts button.

A work item can belong to only one interim payment at a time. Billed items drop out of the picker list; they come back when the payment is deleted or the item is removed. The same rule applies to equipment work entries.

**Only work items with the status Done can enter an interim payment**, and an item with no payment type is not listed at all: it is unclear which agreement it would be paid from. Both are set in Field Progress.

An interim payment with no items is real. You can create the record and add the items later; the table writes No items rather than zero on that row, and the panel explains why.

When you select a date range, interim payments with no date drop out of the list. They are not lost; they come back when you clear the filter.

The search respects Turkish letters. Typing yilmaz finds Yılmaz İnşaat. The search also works on the payment number and the item names; the date of an equipment item does not enter the search — searching by date is the job of the period filter.

Unit names are the values you entered. The common units are shown in the interface language — Gün as day, Saat as hr; any other unit (m²) appears exactly as it was written.

Caution — known defect On a lump-sum agreement whose contract sum was entered as zero, two lines contradict each other: at the top "Contract sum 0.00 ₺", and under the amount box "No contract sum is entered on this agreement; the upper limit cannot be checked." Both say the same thing — there is no upper limit to check. If a sum really is to be entered, correct the agreement in Subcontractors.
Caution — known defect The difference note on the payment certificate says "at current unit prices the items total"; yet unit-price and day rate items are counted in that total at the prices on the day of issue (today's only if those are not known), and lump sum, deduction and equipment items with their recorded amounts.
CautionThe Item total differs badge is not an error; it says the total worked out from the items does not match the recorded amount. The way to remove the badge is to open the payment and save it again — but that pulls the issued payment's amount to the item total and changes the line in the account ledger too. If the day's prices are not known, the form says so with the warning "Unit prices at the time of issue are unknown" and the amount saving would produce. Do not do it without agreeing with the subcontractor.
  • Subcontractors — the companies and the agreements are defined there. An interim payment is always tied to an agreement; the agreement's type, unit price, unit and lump-sum contract sum come from there. An interim payment cannot be issued to a subcontractor with no agreement.
  • Field Progress — the work items that unit-price, day-rate, lump-sum and deduction items are linked to are entered there. An item's payment type and status are set there; billed items appear with a badge and their money fields are locked.
  • Equipment Tracking — the work entries that equipment items come from are kept there. Billed work entries are marked there.
  • Progress Report — whether a work item has entered an interim payment appears there as a column.
  • Accounts — every issued interim payment is written to the subcontractor's ledger as a credit line; the line's date and description go from here.
  • Financials — the subcontractor cost is totalled there together with the other cost items.
  • Overview — the project's twelve-month interim payment chart and total are summarised there.
