05 User Guide

Schedule

Schedule is the page that says when the work will be done. Work items defined in Field Progress are tied here to a subcontractor and to a date range;

1. What it is for

Schedule is the page that says when the work will be done. Work items defined in Field Progress are tied here to a subcontractor and to a date range; the result is a schedule chart that runs from left to right.

A activity is a subcontractor carrying out specific work items within a specific date range. The length of the bar shows the duration, the fill inside it shows how much of that work is finished, and the arrows between bars show which job is waiting for which.

These are the questions the page answers: who has which job this week, which job has slipped, if I pull a job forward, where do the ones behind it move to and when does the programme finish. The schedule can be taken out as Excel, PDF and an AutoCAD drawing.

It is the only page in the app with a time axis. The other pages show a list; here the first axis is time and the second is the work.

2. Opening it, and who can see it

In the sidebar, Site Operations › Schedule.

Your permissionWhat you can do
ViewYou read the chart, filter it, zoom it and export it. The New activity and Folder buttons are not drawn; bars cannot be dragged and the right-click menu comes up empty
EditEverything above, plus adding activities, changing dates, creating links, and defining folders and non-working days
No permissionThe module appears dimmed and locked in the menu
NoteThe export button does not depend on your permission: anyone who can read the chart can take Excel, PDF and DXF. The only thing that disables it is an empty filter.

3. The anatomy of the screen

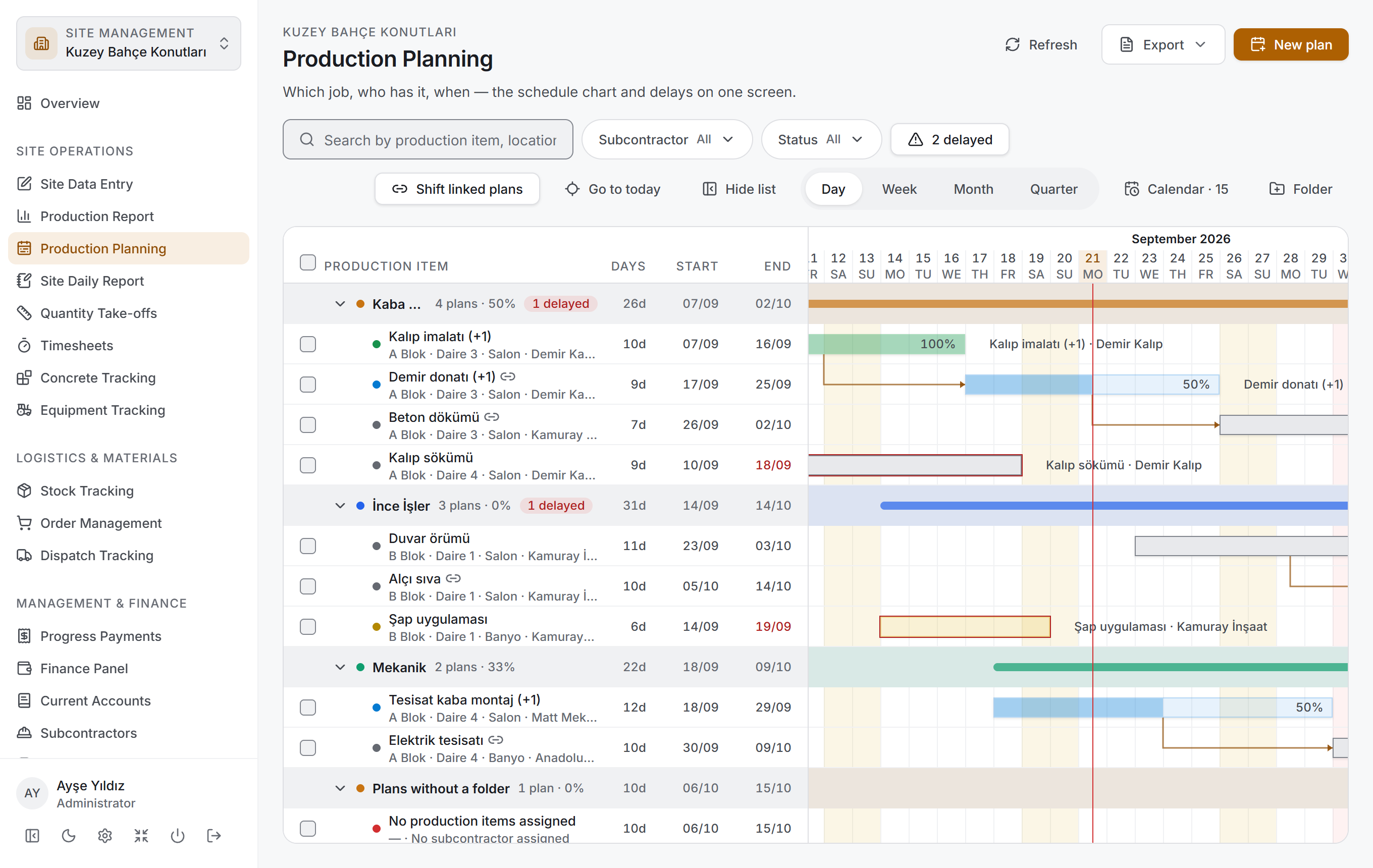

Schedule
NoteThe screenshots in this section contain no real company data; the project, people, company names and dates are examples.

The page has three layers and the chart takes all the remaining height. There is no summary card above the chart: on a schedule chart the most valuable space on screen is the vertical space.

LayerWhat it does
HeaderThe page name, the project name and three actions: Refresh, Export, New activity
ToolbarThe buttons that decide what appears on the chart and how it appears
ChartThe job list on the left, the time axis on the right — inside a single scrolling area

Header and buttons

The title is Schedule, with the project name above it and "Which job, who has it, when — the schedule chart and delays on one screen." below.

ButtonWhat it does
RefreshReads the schedule from the server again. It says Refreshing while it runs

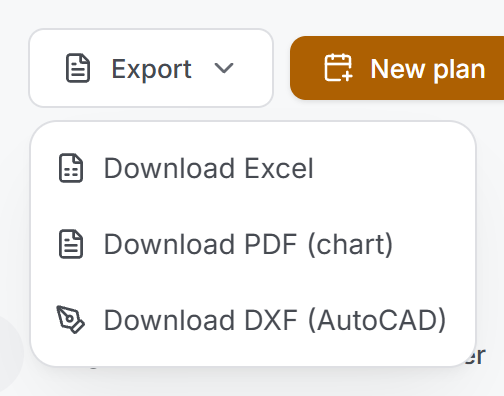

ExportOpens a menu with three choices: Download Excel, Download PDF (chart), Download DXF (AutoCAD). It says Preparing… while it runs
New activityOpens the empty activity window

The Export button is dimmed if the filter brings back no activities — the export of an empty schedule is an empty file. When a file is saved, a green strip appears under the header with the full path of the file; you close the strip yourself with Close.

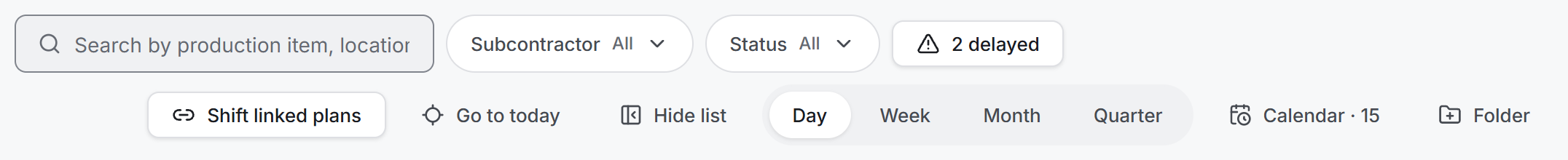

The toolbar

Toolbar

The toolbar has two groups. The first group decides what appears on the chart:

ItemWhat it does
Search activitiesSearches the work item name, location, subcontractor, note and status name at once
SubcontractorThe subcontractors that have work in the schedule; each one shows how many activities it has
StatusThose of the five statuses that actually occur on screen
N delayedFilters down to the delayed activities. It turns red while pressed

The second group decides how the chart looks:

ItemWhat it does
Shift linked activitiesWhen on, later activities linked to a moved activity are shifted by the same number of days
Go to todayScrolls the chart so that today's line is centred
Hide listCloses the left list and gives the full width to the chart. Pressing it again says Show list
Time scaleDay · Week · Month · Quarter — four zoom levels
CalendarOpens the non-working days window. If days are recorded it also writes the count: Calendar · 12
FolderOpens the new folder window

In a wide window both groups fit on one line; in a narrow one the second group wraps to the line below. Their order never changes.

NoteThe N delayed button is only drawn if there is a delay. An empty "0 delayed" button would keep a problem on screen that does not exist.

The left list

The list is a tree: folders and the activities under them. Activities that are in no folder are collected under Activities without a folder.

An activity row has two levels: the work item name on top, the location and the subcontractor below it. The coloured dot in front of the name is the status, and the chain mark next to it says Linked to a previous activity. On the right there are three number columns: DAYS, START, END. The end date is written in red on a delayed activity.

A folder row writes its own colour, its name, how many activities it holds and the total completion rate; if there is a delay inside it, a red number appears next to it. The columns on the right show the number of days the whole folder covers and its first and last date.

You can widen or narrow the list by dragging the thin separator between the list and the chart.

The chart

The right-hand side carries a two-line header and a background beneath it.

ItemWhat it says
Upper header lineMonth, quarter or week — depending on the scale
Lower header lineDay numbers (if the scale is wide enough)
Shaded columnsNon-working days. Hovering over one shows its description
Red vertical lineToday
Coloured bandThe time range a folder covers
BarsThe activities

A bar has square corners and takes its colour from the status. The lighter fill inside it shows the completion rate; if the bar is wide enough, the rate itself is written inside it. The work item name and the subcontractor are always written to the right of the bar — the position does not change however narrow the bar gets. The bar of a delayed activity carries a red frame.

The arrow between two bars says that the later one is linked to the earlier one. It leaves the predecessor from its bottom edge and enters the successor from the left.

The bar details card

The bar details card

When you hover over a bar, a small card opens below it: the activity name, the status badge, the location and four lines — Subcontractor, Dates, Work items, and Delay if there is one. If the activity has a note it appears at the bottom of the card. The card is there so that you can read it without leaving the chart.

4. Fields

The fields in the activity window

FieldWhat it meansRequired
SubcontractorThe company that will do the work. It comes from SubcontractorsYes
StatusPlanned · In progress · Postponed · Completed · CancelledNo, the default is Planned
FolderWhich heading the activity will sit under in the listNo
StartThe first day of the barYes
EndThe last day of the bar. Above the box it says how many calendar days the activity comes toYes
Previous activityThe activity this one waits for. Selecting it draws an arrow on the chartNo
Scope of workThe work items the activity covers. The completion rate is calculated from themNo, but with an empty scope the rate stays at 0%
NotesFree text. It appears on the bar's details cardNo

The values read from the chart

ValueHow it is calculated
DaysThe number of calendar days, start and end included. Non-working days are counted too
CompletionThe share of the linked work items marked Done
StatusBy the rule below; partly measured, partly read from the record
DelayOn activities whose end date has passed and that are still not finished, how many days have passed since the end date

The status comes from two sources. If the record says Cancelled or Postponed, that is what stays — these are a decision, not a measurement. The other three are measured: if every work item in the scope is finished the status is Completed, if some of them are finished it is In progress, and if none of them are it is whatever the record says.

The non-working day fields

FieldWhat it means
DateThe day that will not be worked
TypeWeekend · Public holiday · Site-specific
DescriptionFree text, shown when you hover over that day on the chart

5. Step by step

5.1 Creating an activity

The activity window

  1. Press New activity in the header. To add it straight into a folder, right-click that folder and choose New activity inside.
  2. Fill in Subcontractor, Start and End. When you pick the start date and the end is empty, the end is pulled to the same day; a one-day activity is the most common shape.
  3. Choose Status, Folder and Previous activity if you need them.
  4. Tick the work items the activity covers under Scope of work.
  5. Write Notes if you want to, and press Create.

If a required field is empty, a warning appears at the top of the window: "Subcontractor, start date and end date are required." If the end date is before the start date a separate warning appears and nothing is saved.

NoteAn activity can be saved without work items; settling the calendar first and filling in the scope later is a legitimate way to work. But the window says what that means: the completion rate of an activity with an empty scope cannot be calculated, and its bar will always look empty.

5.2 Choosing the scope of work

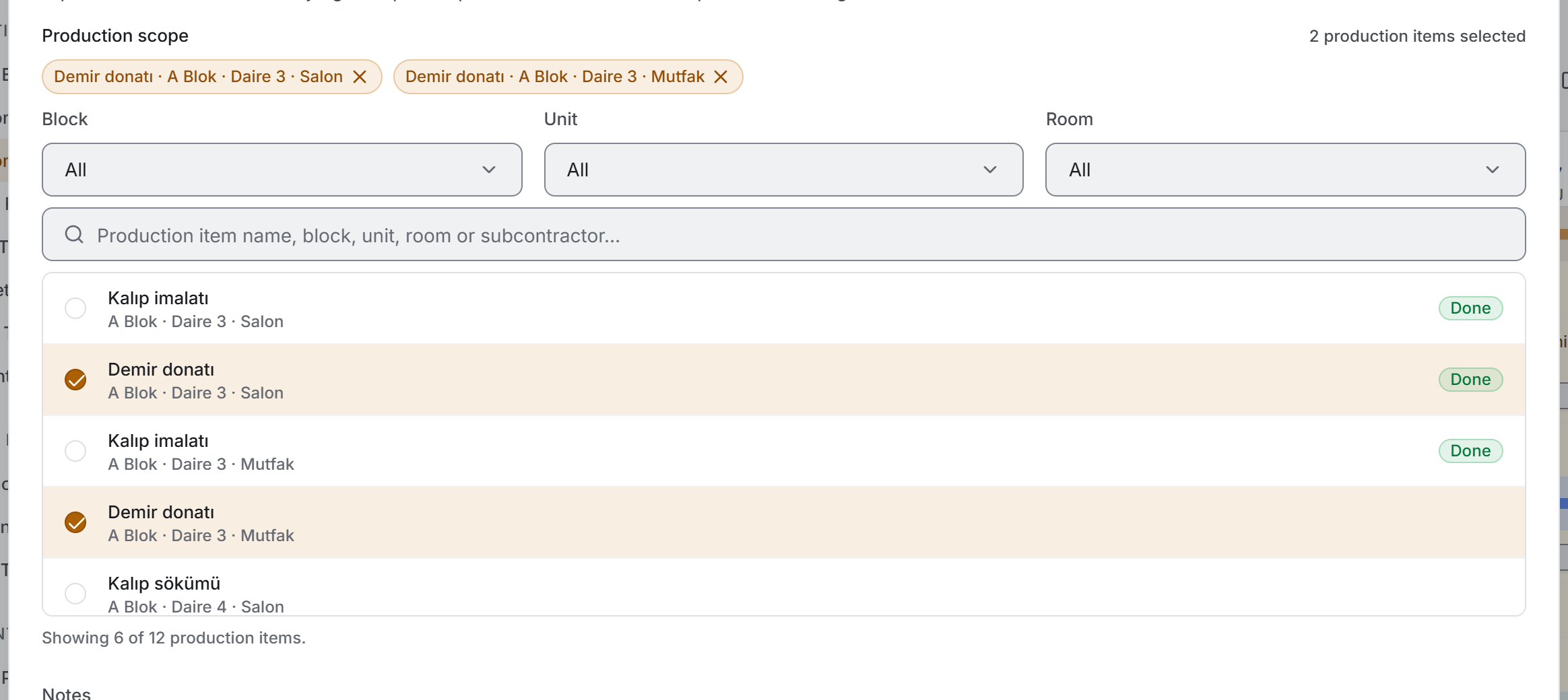

Scope of work

A project can hold thousands of work items; the window narrows the list in three stages.

  1. Fill in the Subcontractor box at the top of the window — the activity's subcontractor also narrows this list. It comes down to the work items assigned to that subcontractor and those that have no subcontractor yet; work assigned to another subcontractor drops out.
  2. Narrow the location with the Building, Unit and Area boxes. All three are optional; when an upper level changes, the ones below it return to All.
  3. Type into the Search work items box. The search moves inside the narrowed pool.
  4. Tick an item by clicking its row. What you pick collects at the top of the list as removable chips; items already finished on site carry a Done badge.

The line under the list says how many work items are shown. If the pool holds more than 300 records, only the first 300 are drawn and you are asked to narrow it down; as the filters do their work, that warning disappears on its own.

When the pool empties, the list says "No work items for the selected subcontractor and location. Loosen the filters." — that is, it says the problem is in the filters, not in the search.

5.3 Changing dates from the chart

There is no need to open a window; the bar itself carries three handles.

  1. Grab it by the body and drag — the activity moves forward or back without its duration changing.
  2. Pull its right edge — the end date changes and the start stays where it is.
  3. It is written when you let go. While you drag, the new date range appears next to the bar.
NoteThe shortest activity is one day: however far left you pull the bar, the end never goes before the start. If the dates have not actually changed, nothing is sent to the server.

5.4 Linking two activities

  1. Hover over the predecessor bar. A small ring appears at its right end.
  2. Grab the ring and drag it onto the successor bar. A dashed line follows you while you drag, and a valid target is highlighted.
  3. Let go. The successor's Previous activity field is now the predecessor, and an arrow is drawn between the two bars.

To remove a link, right-click the successor activity and choose Remove link. The same link can also be made from the Previous activity box in the activity window; there you also get a Move to the day after the previous activity button, which shifts the start with one click.

5.5 Shifting the chain together

When Shift linked activities is on and you move an activity, the later activities linked to it are shifted by the same number of days. When it is done the screen says "3 linked activities were also shifted."

When it is off, only the activity you are holding moves; the arrows stay where they are and the overlap becomes visible on screen.

CautionShifting the chain writes several records to the server. On a long chain the operation can take a second or two; do not disturb the chart while it runs.

5.6 Moving around the chart

What you wantHow
To zoomCtrl + mouse wheel, or the Time scale on the toolbar
To move sidewaysAlt + wheel or Shift + wheel
To drag freelyHold the middle mouse button and drag
To come back to todayGo to today
To give the chart the full widthHide list

While you zoom with Ctrl, the day under the pointer stays where it is; moving between two levels does not drop you somewhere else in the schedule.

5.7 Organising with folders

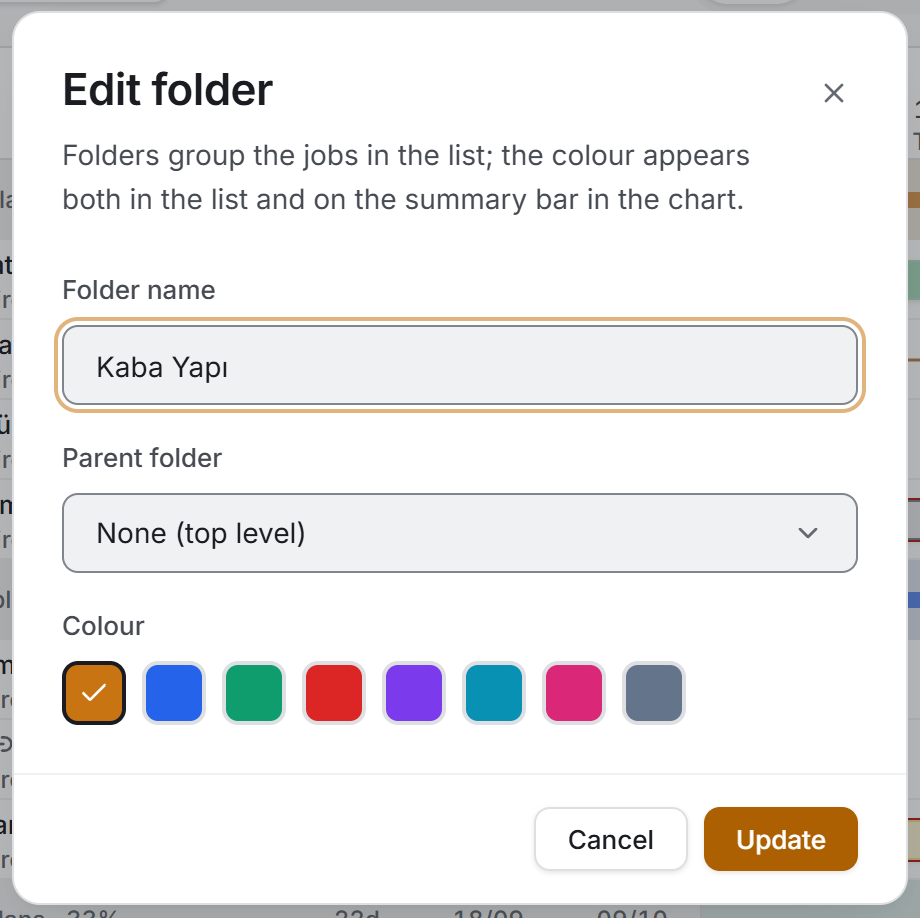

The folder window

Folders group the jobs in the schedule — Structural work, Finishes, Mechanical and so on.

  1. Press the Folder button on the toolbar; to put it under another folder, right-click that folder and choose New subfolder inside.
  2. Write a Folder name, choose a Parent folder if you need one, and pick one of the eight colours.
  3. Press Create.

The colour appears both as the dot in the list and as the band on the chart. To move an activity into another folder, grab its row in the list and drag it onto the target; as you move it to the right the row indents and shows you in advance where it will land.

NoteDeleting a folder does not delete the activities inside it. The activities move to the top level and appear in the list under Activities without a folder.

5.8 Defining non-working days

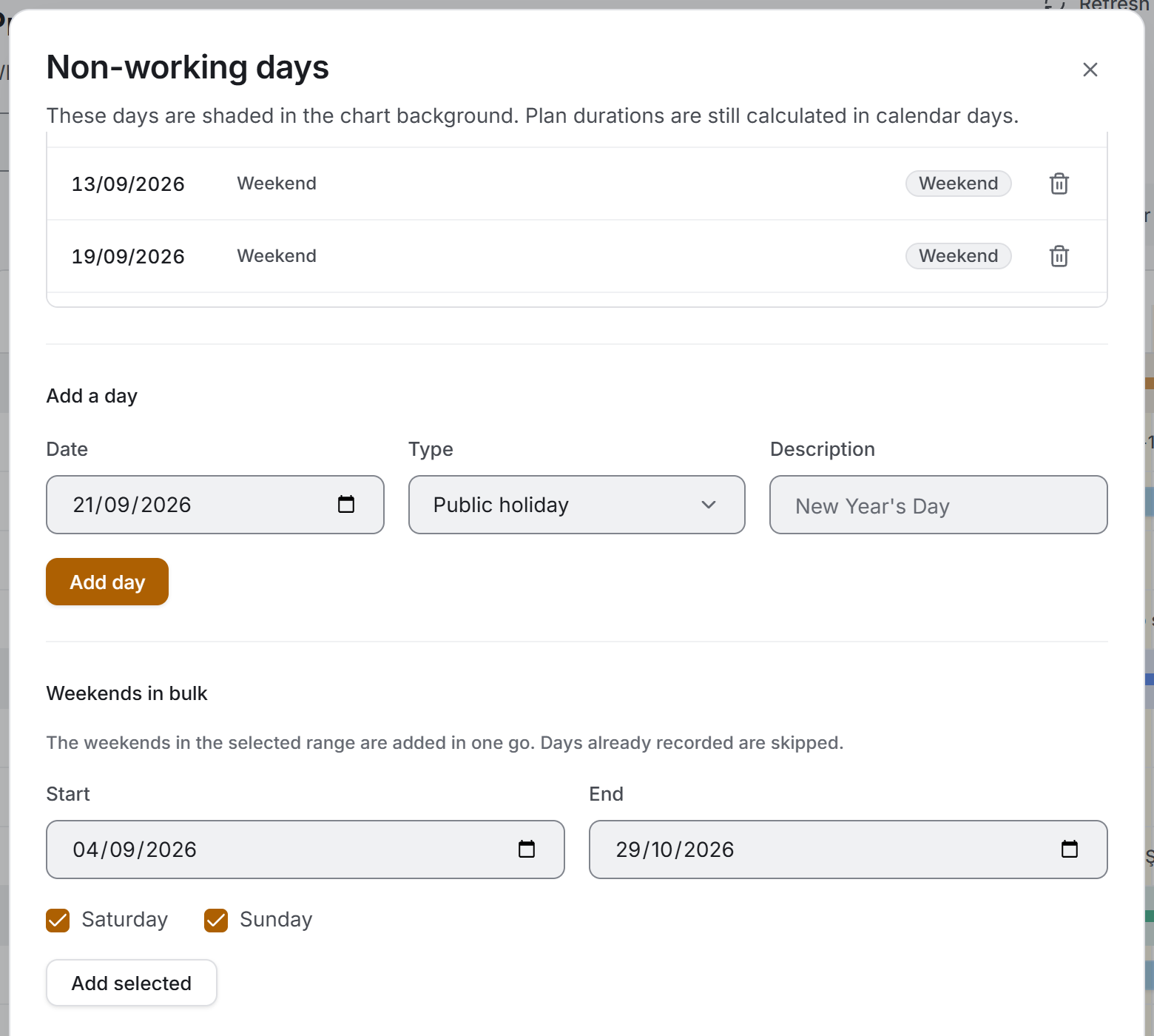

The calendar window
  1. Press the Calendar button on the toolbar.
  2. In the Add a day section pick the date, mark the Type and write a description if you want to — New Year's Day, for instance. Press Add day.
  3. Instead of entering weekends one by one, use the Weekends in bulk section. The date range comes ready with the chart's current range; tick Saturday and Sunday as you need and press Add selected. When it is done it says how many days were added.

The recorded days are listed in the upper half of the window; the bin at the end of each row deletes that day.

NoteThe same day is never added twice. If you pick a date that is already recorded the window warns you; in a bulk addition the recorded days are skipped quietly and it says "No new days to add in the selected range."
CautionNon-working days are only shaded in the background. Activity durations are still calculated in calendar days: an activity that runs across a weekend does not get longer.

5.9 Deleting an activity

  1. Right-click the activity and choose Delete.
  2. The window that opens says what will happen: the work items linked to the activity stay on the server and only lose their place in this schedule; the links from later activities that follow this one are broken.
  3. Press Delete.

5.10 Deleting several activities at once

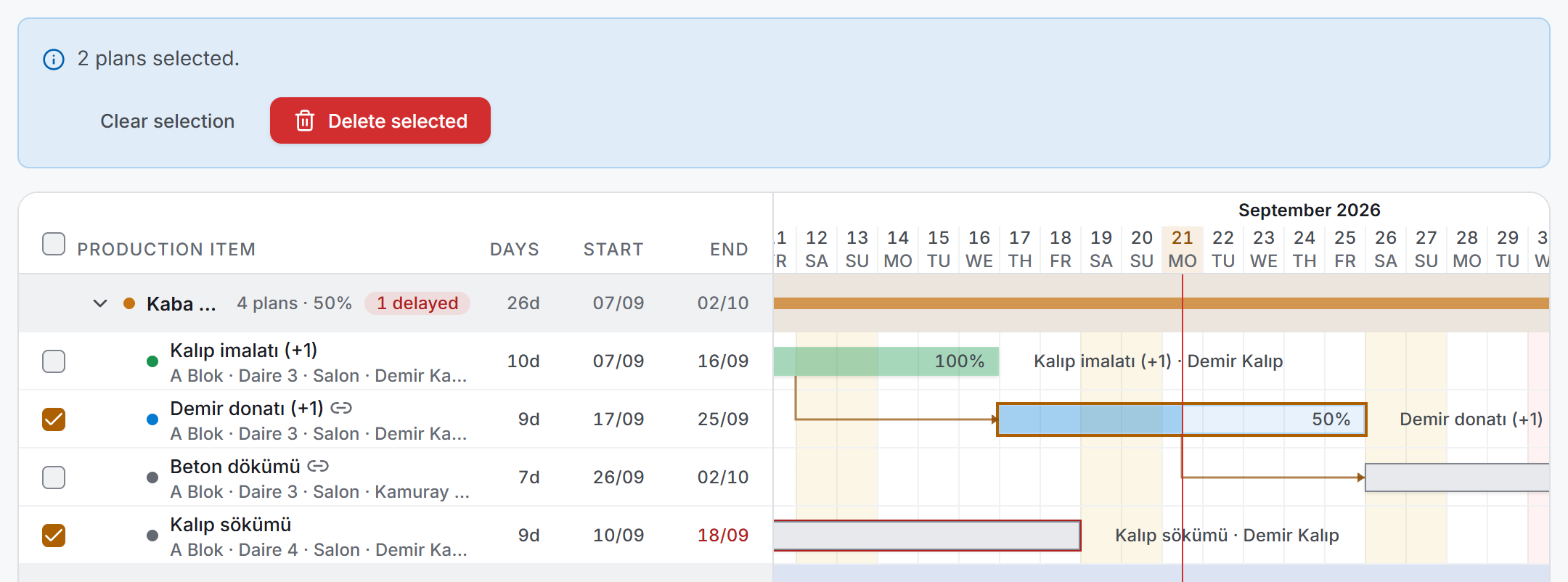

The selection strip
  1. Tick the boxes at the start of the activity rows in the list. The box in the header selects every visible activity. Ctrl + click flips a single record and Shift + click adds the rows in between; both also work on the bars.
  2. A strip appears saying "7 activities selected."
  3. Press Delete selected and confirm. The window writes the names of the first five activities and collects the rest as "… and 3 more activities."

When it is finished it says how many were deleted. If some of them could not be deleted that is said too, and the ones that failed stay selected, so you do not have to tick them again to try once more.

NoteFolders do not take part in the selection; the place of the box is left empty on a folder row. Deleting a folder is a different thing anyway — it does not delete the activities inside it, it moves them.

6. Exports

The export menu

All three exports write the filter that is on screen. When you press the button the Windows save window opens; the file name comes ready as Schedule_… with a date stamp at the end. If you press Cancel nothing is written.

Excel

A workbook with three sheets:

SheetWhat is in it
ScheduleThe activity rows, together with their folder
Subcontractor LoadWho has how many activities, how many days, how many are delayed, and the completion rate
Non-working DaysThe calendar records: date, type, description

The columns of the Schedule sheet are: Folder · Work item · Location · Subcontractor · Status · Start · End · Days · Work items · Completed · Rate % · Delay (days) · Previous activity · Note.

Each sheet opens with the project name, the date and the filter that was applied. The header row is frozen and carries an auto-filter. Numbers are written as real numbers and dates as real dates; whoever opens the file can build their own calculation.

NoteIn the old application this page had no Excel export at all; the schedule could only be taken out as a drawing.

PDF

A landscape A4 document, and what is inside it is the chart itself — a drawing, not a table.

  • The top of the first page carries SCHEDULE, the project name and the date it was prepared. The strip below writes the schedule range, the number of activities, and the numbers in progress, delayed and completed.
  • The left column carries the WORK ITEM / FOLDER details, and the bar of that row is drawn to its right. The time axis is fitted to the width of the page.
  • The day lines, day numbers, non-working day shading, dependency arrows, completion fill and delay marks are the same as on screen.
  • A dashed red line marks the day the document was prepared.
  • The chart is followed by the Subcontractor load table, and notes at the very end.
  • The bottom of every page carries the project name, the document name and the filter applied.

If the scale becomes too narrow, the day lines and day numbers are not drawn; a squeezed grid would turn into an unreadable grey block.

DXF (AutoCAD)

The CAD drawing of the schedule. The same chart, written out in layers:

LayerWhat is in it
0-FRAMEThe frame and the header grid
0-DAY · 0-HOLIDAYDay lines and non-working day columns
1-TEXTWork item names, rates, dates
2-FOLDERFolder bands
3-TODAYToday's line
4-LINKDependency arrows
BAR-…The bars, five separate layers by status

The layers are there so that you can switch off what you do not want when you bring the drawing into your own sheet: if the day grid is too busy, 0-DAY is turned off and the chart itself stays.

NoteIn DXF the day lines are drawn at every scale. Unlike the PDF, the drawing can be enlarged; a line that cannot be read on screen becomes readable when you zoom in.

The long schedule warning

If more than 400 rows go into the chart, the PDF asks first: "The schedule is very long." The window says how many rows will be printed and that the window may not respond for a few seconds while it is prepared. To carry on, press Prepare anyway.

NoteThe dates inside the exports are written as day.month.year whatever the language of the app. This is a known limitation of the export files.

7. Things worth knowing

The duration is in calendar days. Non-working days are shaded in the background of the chart but do not affect the duration. A five-day job that runs across a Sunday is still five days. This is a deliberate decision: the definition of a "working day" changes from site to site, and a schedule whose day count did not match the difference between two dates on the calendar would create a bigger confusion.

The completion rate comes from Field Progress. For an activity's bar to fill, the work items in its scope have to be marked Done there. Nothing can be marked done from this page.

Cancelled and Postponed are not overwritten by measurement. Every other status is calculated from the work items in the scope, but these two stay as the record has them. A work item inside a cancelled activity being done on site does not turn the activity back into In progress.

An activity with no dates has no bar. Records that came from the old application, or whose dates were cleared, stay in the list, show a dash in the days column and appear nowhere on the chart. The notes line of the exports says how many such activities there are.

A delay is an alarm, not a status. Every activity whose end date has passed and that is still not completed counts as delayed; you do not have to select a status as well. Cancelled and Completed activities produce no delay.

Search and filter work together. The search box searches the work item name, location, subcontractor, note and status name at once, while the filter chips narrow the pool. When both are on, the result is the intersection of the two.

The rate inside a bar is not always written. When the bar stays narrow the rate is not written but the fill is still visible; to read the number, either zoom in or hover over the bar and look at the details card.

The schedule is a snapshot. The data comes down once when the page opens and does not refresh by itself while you work with the filters. If someone else has added an activity in the meantime, you have to press Refresh to see it.

The successors of a deleted activity are set free. Deleting first breaks the links of the records that point to that activity as their previous activity. That is why some arrows disappear after a deletion; what is lost is not the arrow but a link that no longer exists.

Fields left empty have a stand-in in the list. An activity with an empty scope appears as No work items assigned, an activity without a subcontractor as No subcontractor assigned, and activities that are in no folder under the heading Activities without a folder. None of the three is a real name; each stands in for a field that was not filled in.

The subcontractor name comes from Subcontractors. If a company has been deleted there, the activity shows Deleted subcontractor; if none was ever assigned, No subcontractor assigned. Both can be picked from the filter.

Bulk selection only covers what is visible. The box in the header selects the activities that match the filter on screen. Putting a record hidden by a filter into a delete list would mean deleting something you cannot see.

  • Field Progress — the work items an activity covers are defined there, and marked Done there. Whether the bars fill depends on it.
  • Progress Report — tells the status distribution of the same work items; this page spreads the same work across time.
  • Subcontractors — the subcontractor list in the activity window and the Subcontractor Load sheet in the export are fed from there.
  • Overview — reads the general progress of the project; the delay against the programme is here, the completion is there.
  • Daily Report — writes how much of the planned work was actually done on site that day.
